Construction input prices rose 8.0% through May 2026, the fastest twelve-month increase since the pandemic. Demand did not do that.
Aluminum mill shapes were up 33.0% year over year in January 2026 and steel mill products 20.7%, while project starts were flat and the labor gap was shrinking.
When the cost line stops tracking demand and starts tracking tariff schedules, canal drafts, and freight reroutes, the materials line stops behaving like a market price and starts behaving like a tax. It does not ease when your leasing slows.
Market Signal
The Bureau of Labor Statistics index for net inputs to construction rose 3.5% across calendar 2025. That is a normal year. It then rose 8.0% in the twelve months to May 2026, with 1.7% in May alone. The Associated General Contractors of America, reading the same series, called it the largest year-over-year jump since the pandemic.
So this is not a slow grind that has been running since 2021. It is a step change that landed in the first half of 2026, and it landed while demand was soft.
The proximate cause is documented and dated. Presidential Proclamation 10947, signed June 3, 2025, raised the Section 232 tariff on steel and aluminum imports from 25% to 50%, effective 12:01 a.m. on June 4, 2025. The 25% rate had itself been set only in February of that year.
A tariff on an intermediate good behaves differently from a demand shock. It sets a floor. Demand can fall, and the floor stays where it is, which is why the index kept climbing through a period when nobody was describing the market as hot.

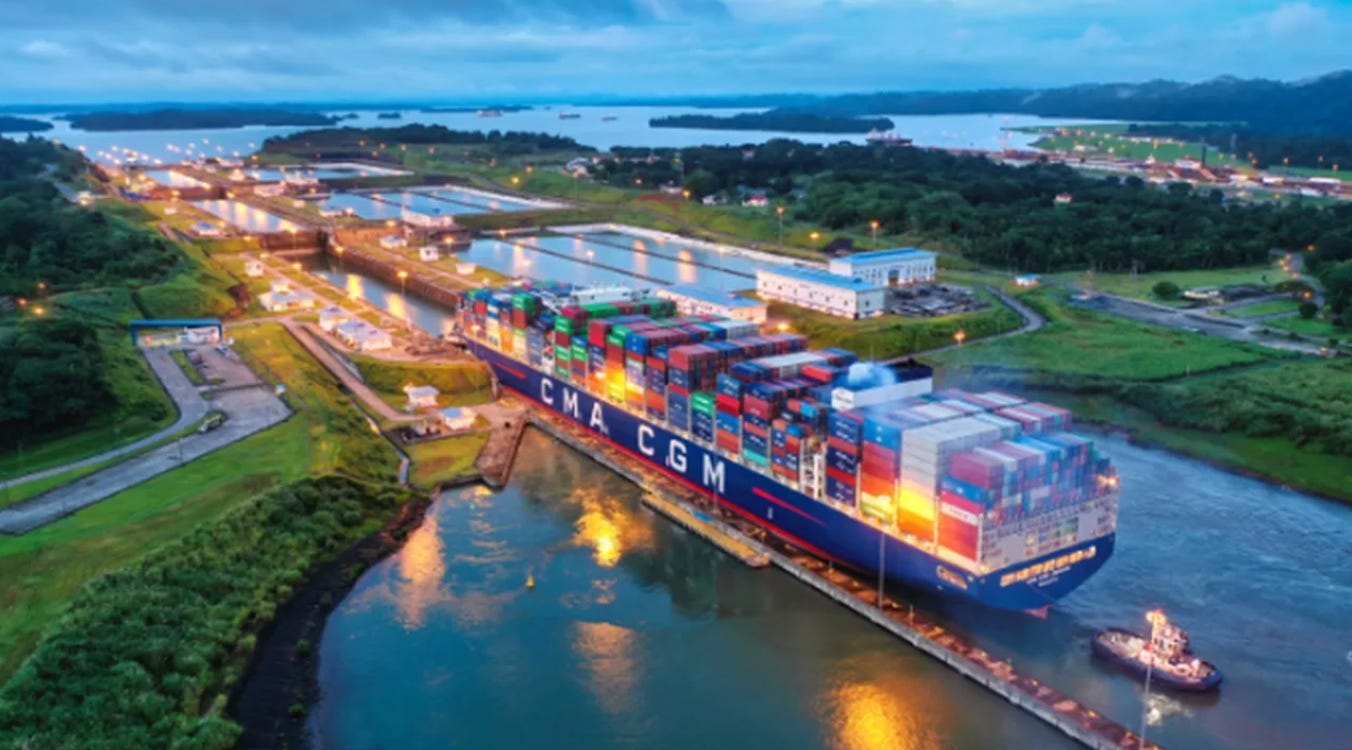

A second force is underneath, and it is the one these briefs have tracked all year. The Panama Canal cut transits by 21% in fiscal 2024, to 9,944 from 12,638, as drought forced water conservation. The Canal Authority reduced daily slots from a normal 36 to 22 at the trough in late 2023, restoring 24 from mid-January 2024.
That was not a one-time event. On August 5, 2026, the Canal Authority set a maximum authorized Neopanamax draft of 48.0 feet, with 47.5 feet to follow, “aimed at ensuring the long-term sustainability of its operations” while its specialists assess “the potential impacts of the El Niño phenomenon.” On August 20, it went further, cutting daily slots at the Neopanamax Locks to nine from September 3 and at the Panamax Locks to 25, then 23 from September 15, and moved the draft dates to September 2 and October 1.
The National Oceanic and Atmospheric Administration’s Climate Prediction Center puts a number on that phenomenon. As of August 13, 2026, it carries an El Niño Advisory, with a greater than 90% chance of a very strong event over the coming fall and winter and a 69% chance of an event in October through December exceeding any since 1950.
A draft restriction is a capacity restriction. A ship that cannot load to its marks either carries less or goes around, and both show up in your landed cost and your lead time.
Case Study
Australia ran the experiment that shows what happens when a builder absorbs all of this on a fixed price. The results are on the public record, and worth reading closely.
The Australian Bureau of Statistics measured input prices to house construction rising 17.3% in the twelve months to the June quarter of 2022. Output prices, what builders charge, rose 40.8% between the September quarter of 2020 and the June quarter of 2024.
Note that those two indices measure different things. The first is what a builder pays. The second is what a builder can charge. The gap between them, and the lag, is where the damage happens.
In calendar 2024, 3,217 Australian construction firms entered external administration, up from 2,546 the year before, a rise of roughly 26%. On the financial-year series, the Australian Securities and Investments Commission reports construction insolvencies climbing from 2,213 in 2022-23 to 2,977 in 2023-24 to 3,596 in 2024-25.
Housing demand was strong throughout. The homes were selling. What failed was the procurement structure.
Australian residential builders sign fixed-price contracts because the law and the lenders require it. Under section 13 of Victoria’s Domestic Building Contracts Act 1995, a builder may not enter a cost-plus contract unless the work falls in a class the regulations permit or “the work to be carried out under the contract involves the renovation, restoration or refurbishment of an existing building and it is not possible to calculate the cost of a substantial part of the work without carrying out some domestic building work.”
The permitted class is defined by value. Regulation 10 of the Domestic Building Contracts Regulations 2017 permits cost-plus only where a contract, entered into on or after August 1, 2017, “is reasonably estimated will cost $1 000 000 or more.”
So the prohibition bites hardest exactly where it was meant to protect: the standard new residential build under a million dollars. A consumer-protection rule written to stop mid-build price gouging became the mechanism that transferred the whole supply-chain risk to the party least able to hedge it.
ASIC’s own series, published Jul 13, 2026, shows construction external administrations falling to 3,435 in 2025-26 from 3,596 the year before. That is the first annual decline in five years.
The structural lesson survives that reversal, and it is the only part that travels. More than five thousand builders failed across two years in a market where demand never weakened, because the contract structure, not the market, held the risk. A cycle turning does not undo it. It just means the next shock will find the same architecture waiting.
The transferable point for a US or European operator is not “avoid fixed-price contracts.” It is that the contract structure is itself an underwritten position, and in most pro formas it is invisible, buried inside the unstated assumption that the builder will absorb whatever the supply chain does.
Strategic Implications
Underwrite the procurement structure as a line item. Before you sign, ask who holds the escalation risk and what happens if they cannot. A low bid from a builder who then fails is more expensive than a high bid from one who does not, because you pay the second builder, you pay the carrying cost of the delay, and you pay interest through both.
Read the tariff as a floor, not a spike. The 50% Section 232 rate is a policy setting, and the January 2026 metals numbers, aluminum at 33.0% and steel at 20.7%, are what it produced with demand flat. A model that assumes materials revert when leasing slows is modeling the wrong mechanism.
Price delivery certainty, not just unit cost. A material that is cheaper per ton and arrives weeks late has a cost, and it lands in your interest reserve. Regional sourcing and substitution are now a schedule hedge, which is a different argument from the sustainability one and a stronger one at a credit committee.
Watch the labor number in the right direction. Associated Builders and Contractors estimated the industry needed 439,000 net new workers in 2025 and 349,000 in 2026. That modeled figure comes from the association’s own construction-spending forecast, and it is falling. A shrinking worker gap in a market with rising input costs is not good news. It is a demand signal, and it says the cost pressure is coming from the supply side.
Do not build a resilience case on a green premium above 10%. Certified-building rent premiums that control for age, size, renovation history, and location cluster at 3% to 8%. CBRE’s own study is the cleanest demonstration: LEED-certified buildings’ asking rents run 31% above non-certified peers raw, and 3.7% after controls. The uncontrolled number measures the fact that certified buildings are newer and better located.
Future Signal
The shift worth watching is that supply-chain localization stops being a sustainability story and becomes a delivery-certainty story priced into the schedule.
Mass timber, low-carbon concrete and regional sourcing will be valued less on sticker price and more on whether the material arrives when a canal is throttled or a tariff lands. That is a procurement argument, and procurement arguments reach a credit committee faster than carbon arguments do.
Watch Signal 9, because code is where it gets locked in. When building codes begin to reward or require resilient and lower-carbon materials, today’s premium product becomes tomorrow’s baseline, and the supplier who already controls a compliant regional material is not selling an upgrade. They are selling the only thing you can specify.
The counter-signal is worth holding, too. Federal procurement in the United States moved the other way in 2025: the General Services Administration’s low-embodied-carbon program had obligated $767 million of $2.15 billion when disbursements were frozen in February 2025, and Congress repealed the authorizing section and rescinded the unobligated balance that July. Codes and procurement do not move in one direction, and a thesis that assumes they do will be wrong in at least one jurisdiction.
The physical constraint doesn’t reverse. A canal with less water in it carries less cargo, whatever the policy environment is doing.
As always, KNOW YOUR SIGNALS and BE CLIMATE READY!
